How does a new home get septic in Macon?
A new home on a lot with no sewer line needs four things in order: a soil evaluation, a design sized to the bedroom count, a permit from the Macon-Bibb County Health Department, and an installation that passes inspection before anything is buried. The soil evaluation comes first because it can change where the house goes.
That order matters more here than in many places. Georgia's own survey of the Macon area describes ground that changes sharply across short distances: hilly crystalline-rock upland on the north side of the Fall Line, loose layered sand and clay to the south, and a river floodplain between them. Two lots a mile apart can need two different systems.
This page covers new construction. If you are replacing a failing system on an existing home, see septic tank replacement. If you are still deciding whether septic is the right call at all, start with septic or sewer.



Why check for sewer before you order a soil test
Macon Water Authority runs water, sewer, and stormwater service, and the sewer reaches some parts of the county and not others. Neither the zip code nor a listing description settles it. The authority's customer service line is (478) 464-5600, Monday through Friday, 8 to 5.
If a sewer main is on your street, get the connection details in writing and compare. A septic system has its own costs: the soil evaluation, the permit, the tank, the field, and the grading around it. We will price the septic side for free, and if sewer is the better answer on your lot, we will tell you that too.
There is also a question we have not been able to confirm from public sources: whether a property must connect when sewer is available. Ask the water authority and the county before you assume either way.
What the ground does to a new-home design around Macon
The state survey of the Macon area is old, from 1962, but the geology has not moved. It describes the ground in terms that map directly onto septic decisions. Use the tabs for the zone closest to your lot, and use the Fall Line soil guide for the full cross-section.
North of the Fall Line the land is hilly, over crystalline rock, with water in weathered material and rock fractures. For a new home the questions are slope and depth to rock. Georgia's manual treats slopes over 25 percent as unsuitable without a special investigation, and it wants 2 feet of soil between the bottom of the trench and bedrock.
Along the Ocmulgee and its larger creeks, the alluvium is a mix of clay, sand, and gravel that reaches one to two miles from the river. In flat, slowly draining ground the survey puts the water table within a few feet of the surface. The manual wants 2 feet of separation from seasonal high groundwater, or 1 foot with Class I aerobic pretreatment, and it excludes fill without approval.
South of the line, the sand hills have loose surface sand over layers of red or pink hardpan, and the survey calls them so well drained and coarse that they have low fertility. Water gets away quickly, which helps a field. The evaluator checks what the layers below are doing.
On the clayey uplands, the survey says clay is within a few feet of the surface in most places. Clay takes water slowly, so fields there are often larger or laid out differently. The soil report puts a number on it.
A soil evaluation is the only thing that tells you what your lot does. The zone descriptions explain why the results vary, not what yours will be.
The new-home installation process in Macon, step by step
Confirm sewer status
Call Macon Water Authority, then decide with real numbers whether to pursue septic.
Soil evaluation
A certified soil classifier evaluates the lot. Georgia expects the evaluation to reflect the lot after grading, so tell us how much earthwork is planned.
Design and bedroom count
The system is sized to the bedroom count on the permit and shaped by the soil result: trench field, chambers, pumped, mound, or aerobic pretreatment.
Bibb County Health Department permit
The department reviews the design before you apply for the building permit. This is the compliance step.
Install and inspect

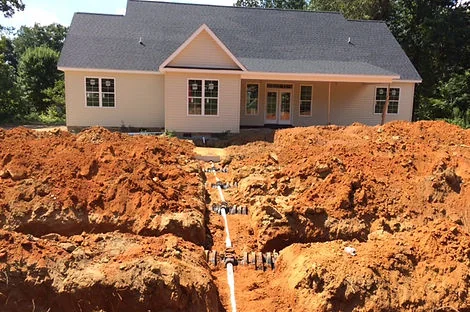

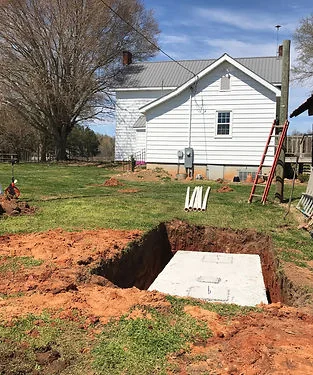

We set the tank, lay the field, call for the inspection before cover, and mark the reserve area.
Where septic fits in your build schedule
Septic is a front-end item. The soil evaluation can move the house, the driveway, even the garage, so it should not be an afterthought once the plans are drawn. Bring us the lot early, ideally before the site plan is final, and we can tell you where the field wants to go.
The installation itself is often a few days of work once permits are in hand. The calendar is set by the appointments around it: the evaluator, the health department, and the inspection. A builder who orders the evaluation late loses weeks, not days.
- Do the soil evaluation before the site plan is final.
- Keep heavy equipment off the field and the reserve area during construction.
- Grade so roof and driveway runoff go around the field, not across it.
- Tell the evaluator about wells, ponds, and drainage ways on or near the lot.
What size tank and how much land does a new house need?
The state health department says average three and four bedroom homes typically use a 1,000 gallon tank, and homes with a garbage disposal need at least 1,500 gallons. For land, it suggests about a half acre for a typical home on public water and about an acre with a private well.
Those are starting points. The field is usually the larger constraint than the tank, and it is sized by the soil. Wider, shallower fields help in slowly draining clay. Pumped or mound designs help where the water table is high. Both are covered on the alternative systems page.
